Short, dated updates from the construction of our future socio-medical community centre in Kawangu, East Sumba. Each entry records a concrete step, document or decision.
23 October 2026: A new 18-page technical coordination document for Building A at Rumah Kambera is online. Revision 0.3 covers 108 proposed electrical, lighting and water points, with solar interfaces and technical schedules. Preliminary,…

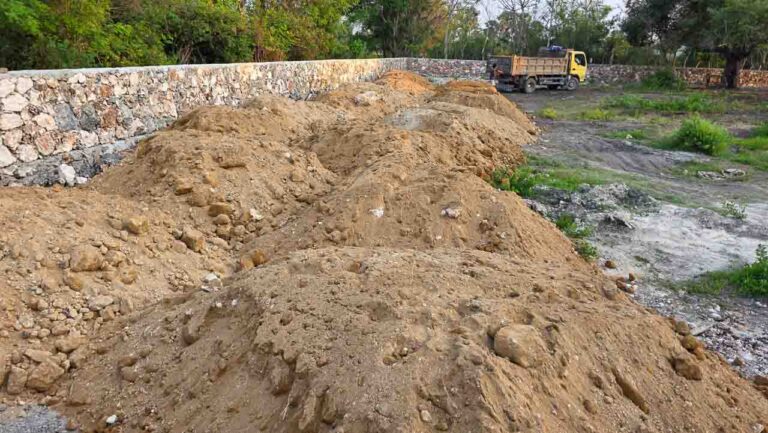

23 October 2026: By yesterday, 75 of the 100 planned sirtu truckloads had arrived at Rumah Kambera. The remaining 25 are expected today, ahead of excavator levelling next week.
20 October 2026: The first day of site levelling at Rumah Kambera brought 21 of 100 planned sirtu truckloads. The work follows the topographic survey and aims to reduce future flood risk.
18 October 2026: Site levelling is planned from 20 October. Around 100 truckloads (1,000 m³) of sirtu will cost IDR 22.5 million, plus IDR 7 million for the excavator to spread and level it.…

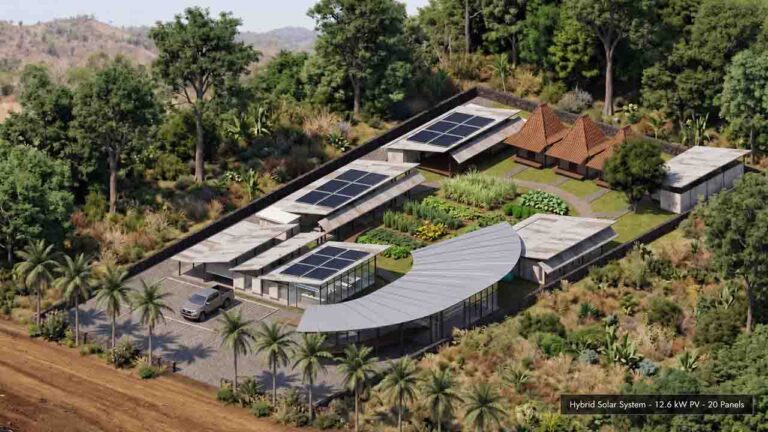

15 October 2026: Smart Energy Tech submitted a 12.6 kWp solar and 32 kWh battery proposal for Rumah Kambera. The Rotary Club Beaulieu Côte d’Azur plans a gala on 23 April 2027 to help…
